Operations and infrastructure

Moving a warehouse onto new software

A warehouse has to keep shipping while each shift learns new handhelds, labels and screens, one area at a time. Here the rollout is one project: the cutover checklists, each area's progress on a board, the vendor's mail, floor photos and the supervisors' end-of-shift answers.

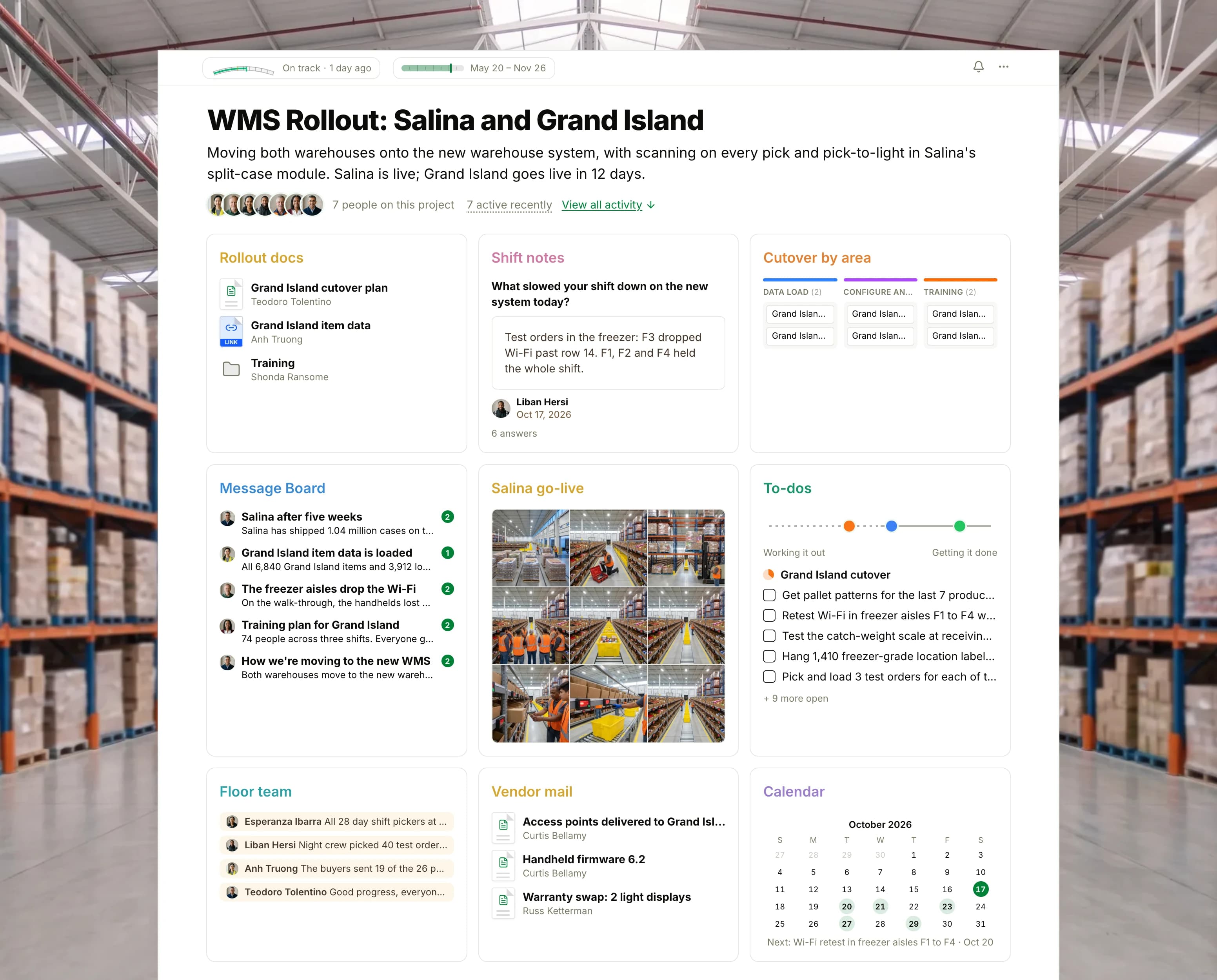

The WMS Rollout: Salina and Grand Island project in Thicket over a photograph of tall pallet racking in a warehouse at dawn: the health flag reading On track, the rollout dates and seven people, then nine cards: Rollout docs with the Grand Island cutover plan, the item data sheet and the training files, Shift notes with the supervisors' answers, the Cutover by area board with cards in Data load, Configure and test, Training and Ready, the Message Board with Salina's five-week numbers on top, Salina go-live as nine photographs of the pick-to-light module and the warehouse floor, To-dos with three lists on the progress chart, the Floor team chat, Vendor mail with the access point delivery and the handheld firmware, and the Calendar with the Wi-Fi retest and the Grand Island go-live.

Smoky Hill Grocers moves each area of its two warehouses through data load, testing and training on Boards. The cutover plan, the vendor's mail and photos from Salina's go-live are in Docs & Files, the Message Board carries each site's numbers, To-dos hold the cutover and training lists, and the Calendar has the Wi-Fi retest and the go-live. The floor team talks in Chat, and supervisors answer one question in Check-ins at the end of every shift.

In this project

The tools on the project's page, in the order shown above, and what each one holds.

  • Docs & FilesRollout docs

    wms-services-agreement-signed.pdf, Floor plans and Wi-Fi maps (3 items), Runbook v5, Training (4 items), Grand Island item data and Grand Island cutover plan

  • Check-insShift notes

    Asks “What slowed your shift down on the new system today?”

  • BoardsCutover by area

    15 cards in Floor requests, Data load, Configure and test, Training, Ready and Done

  • Message Board

    5 posts, the newest “Salina after five weeks”

  • Docs & FilesSalina go-live

    9 pictures

  • To-dos

    Grand Island cutover (5 of 14 done), Grand Island training (2 of 6 done) and Salina follow-ups (5 of 6 done)

  • ChatFloor team

    6 lines from 6 people

  • Docs & FilesVendor mail

    Cold-rated handhelds shipped: 32 units, Parallel run: what our technicians do, Warranty swap: 2 light displays, Handheld firmware 6.2 and Access points delivered to Grand Island

  • Calendar

    8 events, the next “Wi-Fi retest in freezer aisles F1 to F4”
